Grading and Base Preparation in St. George, UT

  • Typical cost: national guides put driveway grading at $700 to $2,500 a job, or about $1 to $2 per sq ft for rough grading and $0.40 to $1 for fine grading.
  • Base course: 6 to 8 inches of compacted gravel under a car driveway, more for trucks (full spec).
  • Clay-rich ground: cost guides say clay soils often need extra excavation and base to prevent cracking and settling.

St. George Asphalt Co. connects you with a local contractor whose grading crew shapes, compacts and tests the ground before any asphalt is laid. Send the size of the area, what will drive on it, and any spots where water already stands or the ground has sunk.

Grading and Base Preparation Steps Under New Asphalt

Plain gray grader shaping bare tan soil into a sloped driveway bed beside a new stucco home, red cliffs in the distance

Rough grading and slope for runoff

Rough grading moves soil to set the overall shape: cutting high spots, filling low ones and giving the surface a fall that carries water away from the house and off the pavement. In St. George, where runoff goes matters beyond puddles. Water soaking into gypsum-bearing ground dissolves the gypsum, and the Utah Geological Survey lists street, roof and parking lot runoff and irrigation among the things that speed that up. Sizing the drains themselves is covered on driveway drainage.

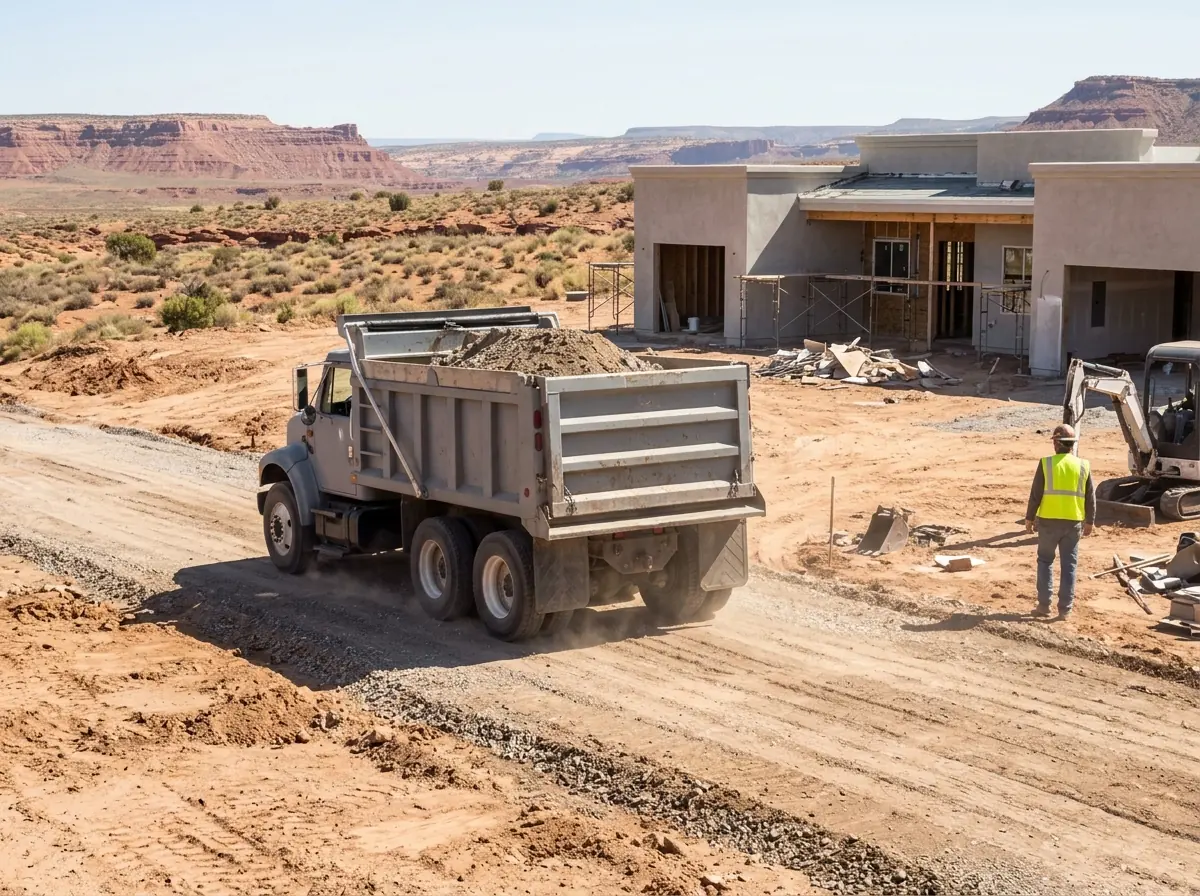

Loaded gray dump truck driving slowly over a compacted dirt subgrade for a driveway while a worker seen from behind watches the tires

Subgrade compaction and proof rolling

Once the shape is right, the native soil (the subgrade) is compacted, then tested. A proof roll looks at the whole surface rather than a few test spots:

  • Equipment: a tandem-axle dump truck, or a tri-axle with the third axle raised, loaded to at least 20 tons; a towed roller of at least 40 tons is the alternative.
  • Pass criteria: a single pass, with about 1 inch of deflection at most and no pumping or cracking.
  • Scope: the research applies it to the subgrade only, not to each layer of base.

Those numbers come from an Indiana DOT highway study. A driveway crew may use a lighter loaded truck, but the idea is the same: find soft spots while they are still cheap to fix.

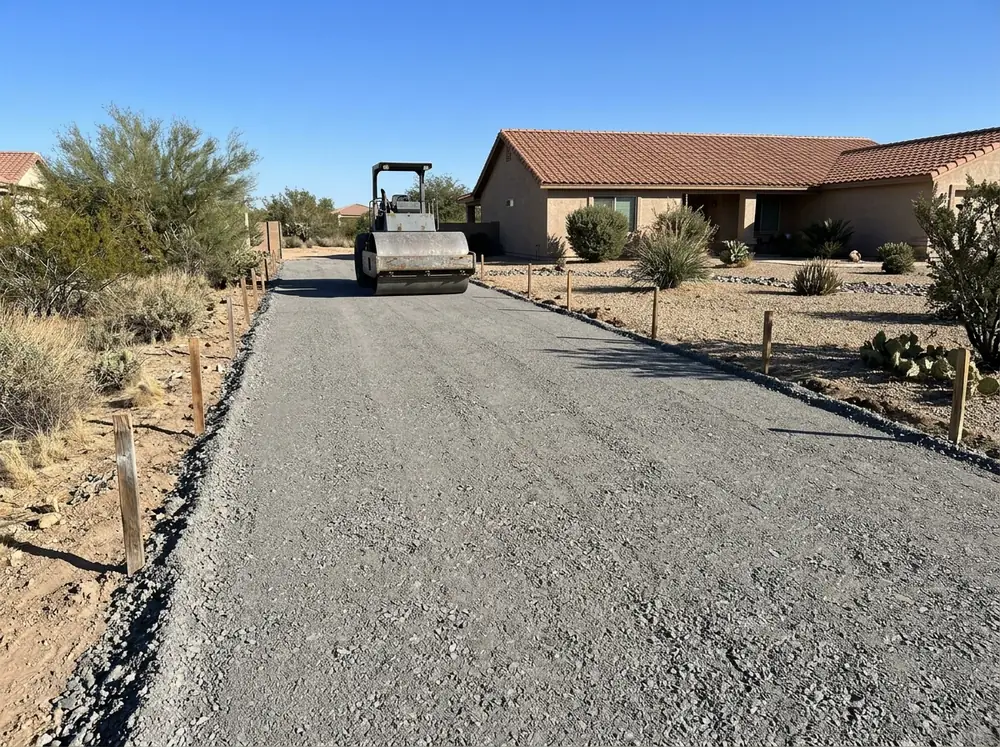

Layer of gray crushed road base spread and rolled flat over a prepared driveway bed, edges staked

Road-base gravel course

The base course is the crushed stone that actually carries the asphalt. Angular stone mixed with sand and stone dust (often sold as crusher run) packs tightly because the pieces lock together, while rounded rock rolls under load. It goes down in layers, each compacted before the next. Base depth depends on what will drive on it; the figures for cars and heavier vehicles are on asphalt driveway paving, and an RV pad needs the heavier end.

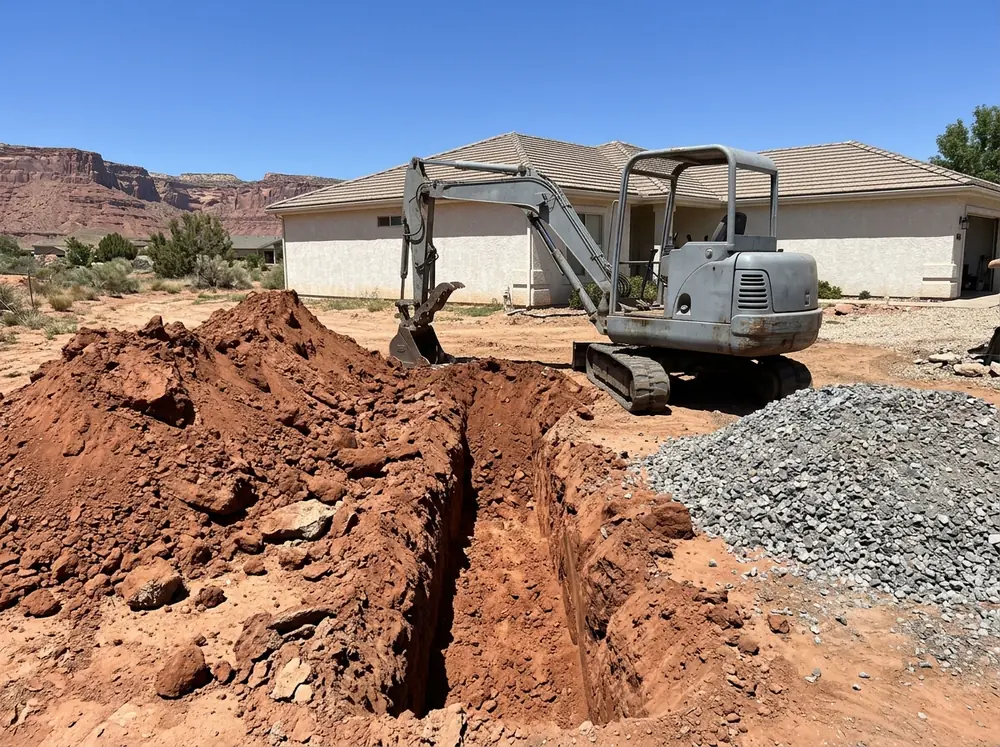

Excavated driveway trench dug well below grade into reddish clay soil, a pile of removed soil and a stack of road base beside it

Over-excavation for expansive and gypsum-bearing soils

Where the soil itself is the problem, the fix is to dig it out deeper than a normal base would need and replace it with compacted, imported material. How deep depends on what the dig finds, so ask whether the bid prices over-excavation as a unit rate (per cubic yard or per inch of depth) instead of a guessed lump sum. The soil types that call for it are listed below.

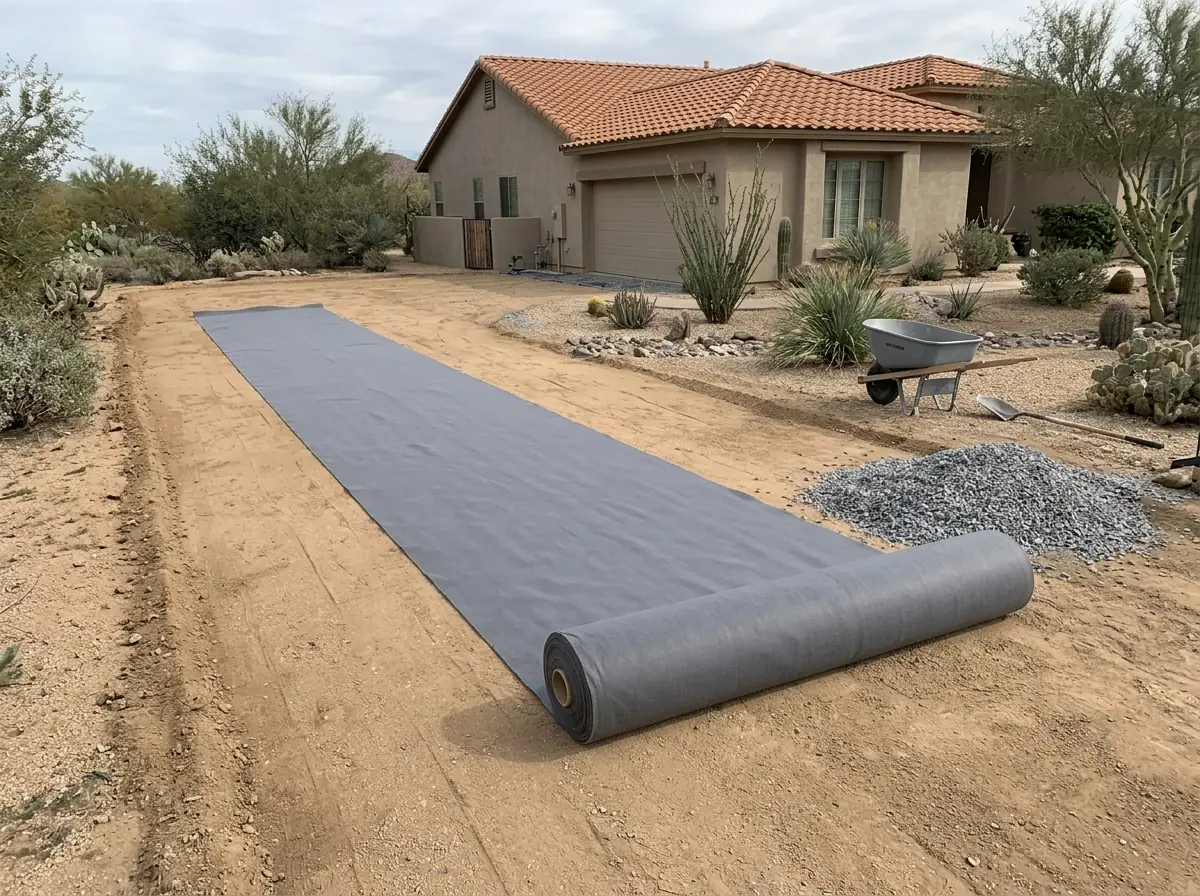

Roll of plain gray geotextile fabric spread over a graded soil bed before gravel base is placed on a driveway

Geotextile fabric under the base

On soft or fine-grained ground, a layer of geotextile fabric can go down before the first lift of base. A Virginia transportation research report describes its main job as keeping the base aggregate and the subgrade fines from mixing, and cost guides say it stops gravel from sinking into the subsoil. It does not replace compaction or a proper base depth.

Small roller compacting fresh asphalt on a residential driveway

Why St. George homeowners and property managers call St. George Asphalt Co.

  • The estimate costs you nothing and commits you to nothing
  • Ask for thickness, base depth and tear-out on the written bid
  • Your job goes to one paving contractor, never a lead auction
  • Property owners pay nothing for the introduction

Get a free asphalt paving estimate

Free for homeowners and property managers. One local contractor contacts you.

St. George Problem Soils That Change the Grading Plan

The Utah Geological Survey calls expansive soil and rock the most troublesome construction condition in southwestern Utah, and its St. George area hazard maps cover several more:

  • Expansive soil and rock

    High-clay material that swells when wet and shrinks when it dries, lifting and dropping whatever sits on it.
  • Gypsum-bearing soil

    Gypsum dissolves in water and the ground loses volume; at 10% gypsum or more, the UGS says this can cause local subsidence and sinkholes. A hard gypsum and calcium-carbonate layer locals call "water rock" can also hold back groundwater that floods an excavation if it's breached.
  • Collapsible soil

    Firm when dry but settles sharply once it's wetted, typically on young alluvial fans and debris-flow deposits.
  • Caliche

    A hard calcium-carbonate layer near the surface in dry climates that can be very difficult to excavate.

The UGS also notes that problem soils can damage pavement after it's built. That is the reason to ask a contractor what they expect to find before digging and how the bid handles it if they find something else.

What to Ask About Grading in a Paving Bid

  • Base depth after compaction

    Is it written in the bid, separate from asphalt thickness?
  • Proof roll

    Will the subgrade be proof-rolled, and who decides what counts as a soft spot?
  • Unexpected soil

    If the dig turns up clay, gypsum or caliche, what is the unit price for going deeper?
  • Spoils

    Is hauling away excavated soil included, or extra?

See driveway drainage for catch basins and swales when grading alone can't move the water.

Frequently asked questions

Why does my driveway need grading if the ground already looks flat?

Flat is the problem. Paving needs a slight, steady fall so rain runs off instead of soaking in at the edges or pooling on the surface. Grading also cuts out soft or organic soil and leaves the subgrade at the right depth below finished height, so the base and asphalt come out even and drain the way the plan says.

What is proof rolling, and should I ask for it?

Proof rolling drives a heavily loaded truck or roller slowly over the prepared subgrade while someone watches for spots that sink, rebound or crack. Those spots get dug out and rebuilt before base and asphalt cover them. Highway agencies use it on roads; on a driveway or RV pad, asking whether the bid includes it is reasonable.

Can I save money by skipping base work?

Base is the last place to cut. Cost guides say clay soils need extra excavation and base, and the Utah Geological Survey notes that problem soils can damage pavement after construction, which means high repair or replacement costs. A thinner base saves money on paving day and moves the risk to later.
