Church and School Parking Lot Projects

Meetinghouse and church lots
A church lot is built for its busiest hour and sits nearly empty most weekdays. That pattern is the scheduling advantage: a contractor can often close the whole lot from Monday to Thursday rather than phasing it in strips, as long as weeknight activities move or park elsewhere. The other pattern is wear. Stalls see light traffic, while the entrance and the lane past the main doors carry every car twice each Sunday, so those areas usually fail first and can be patched or rebuilt ahead of the rest.
When stalls are added or the lot is reworked, the accessible spaces have to match the new total and sit on the shortest accessible route to an entrance. Parking lot striping has the full ADA count table and dimensions.

School drop-off loops and bus lanes

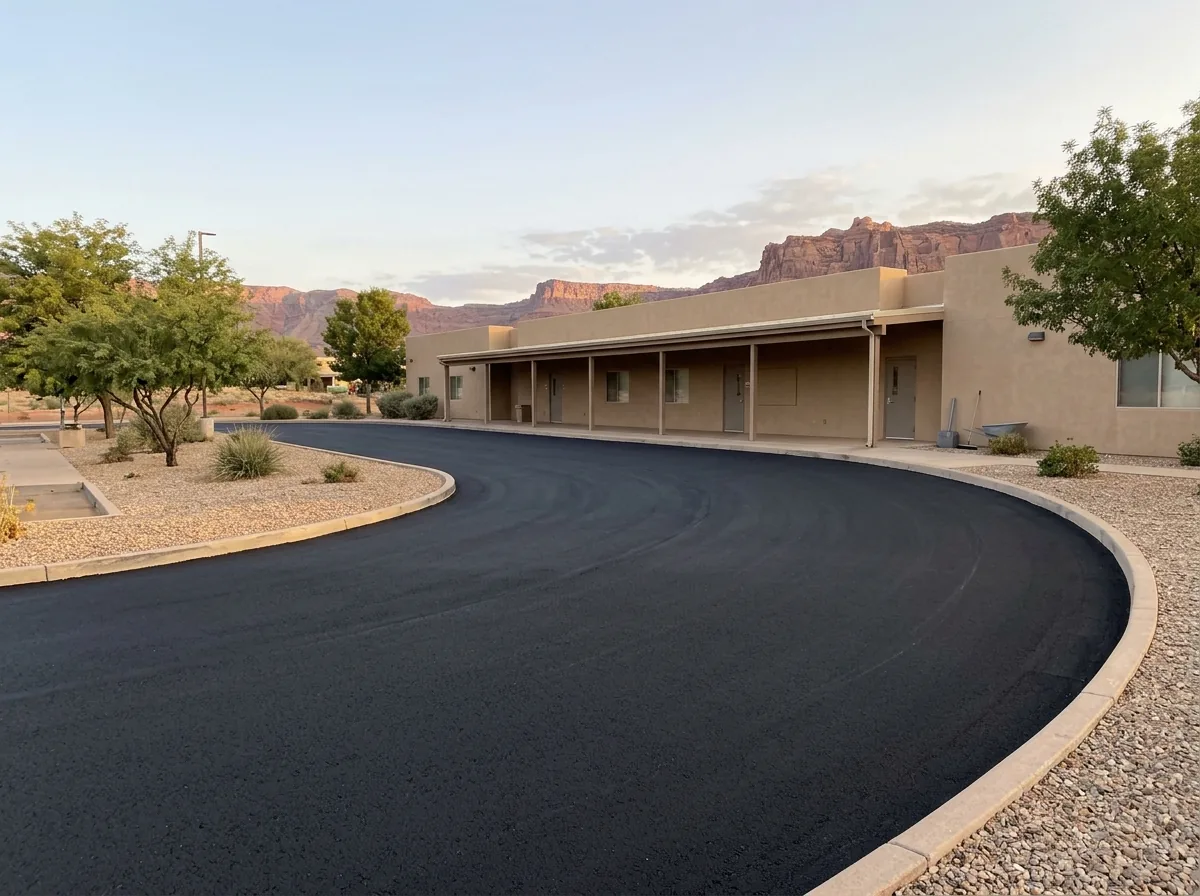

A school lot works differently. Twice a day it fills with a line of idling cars, and buses use the same pavement or a lane of their own. The bus lane is a heavy-vehicle area and should be built like one; the thickness that commercial truck lanes call for is on parking lot paving. Loops are also where layout matters most. A paving project is the cheap moment to lengthen a queue lane so cars stop backing onto the street, separate buses from parents, and add painted crosswalks where children cross. Ask the contractor to stripe from a drawing your principal and transportation staff have signed off on.

Playground blacktop

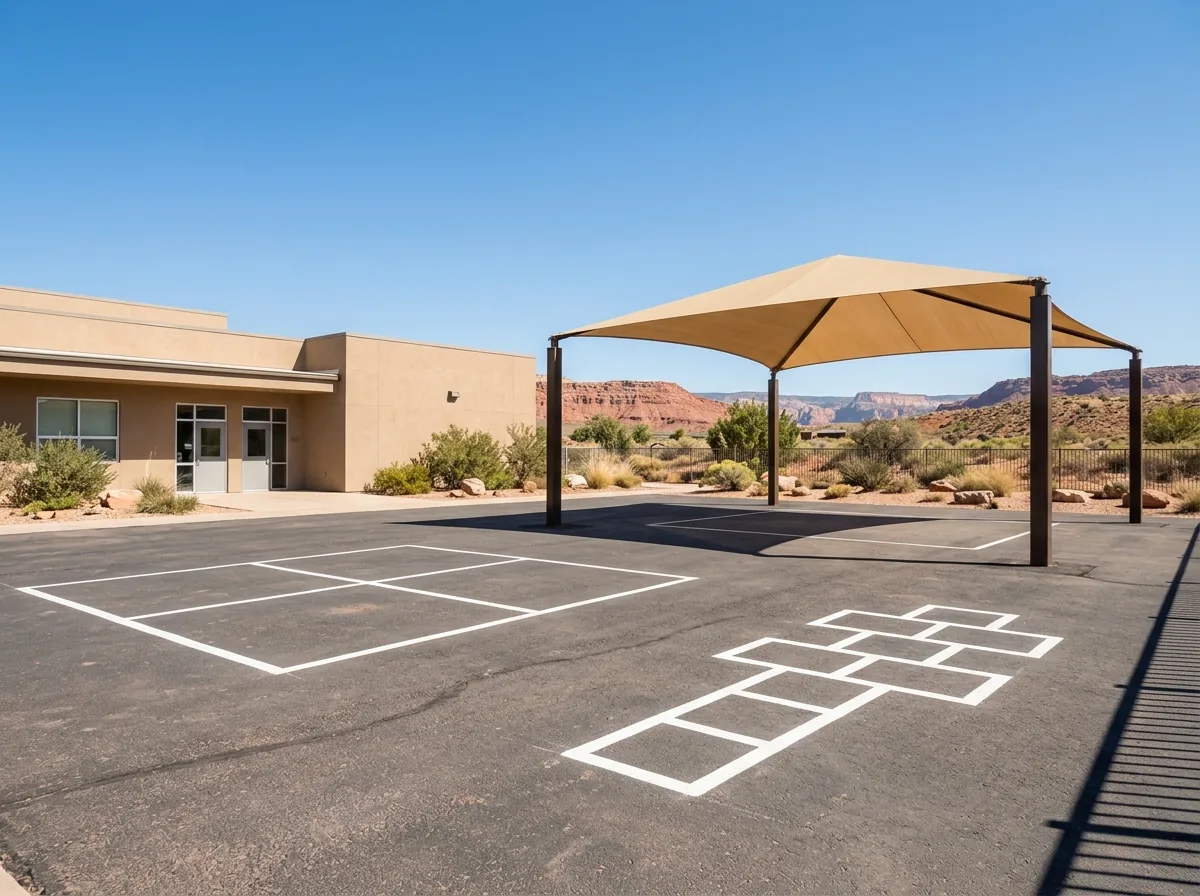

Schools often use asphalt for recess areas and outdoor courts. It's the same paving work as a lot on a smaller scale, but the finish matters more: an even surface without birdbaths, a slope that drains away from doors, and game lines painted after the asphalt has cured. Courts that will get an acrylic color coat need a longer wait before coating, covered with court sizes on sport court paving.

Work scheduled around services and school breaks

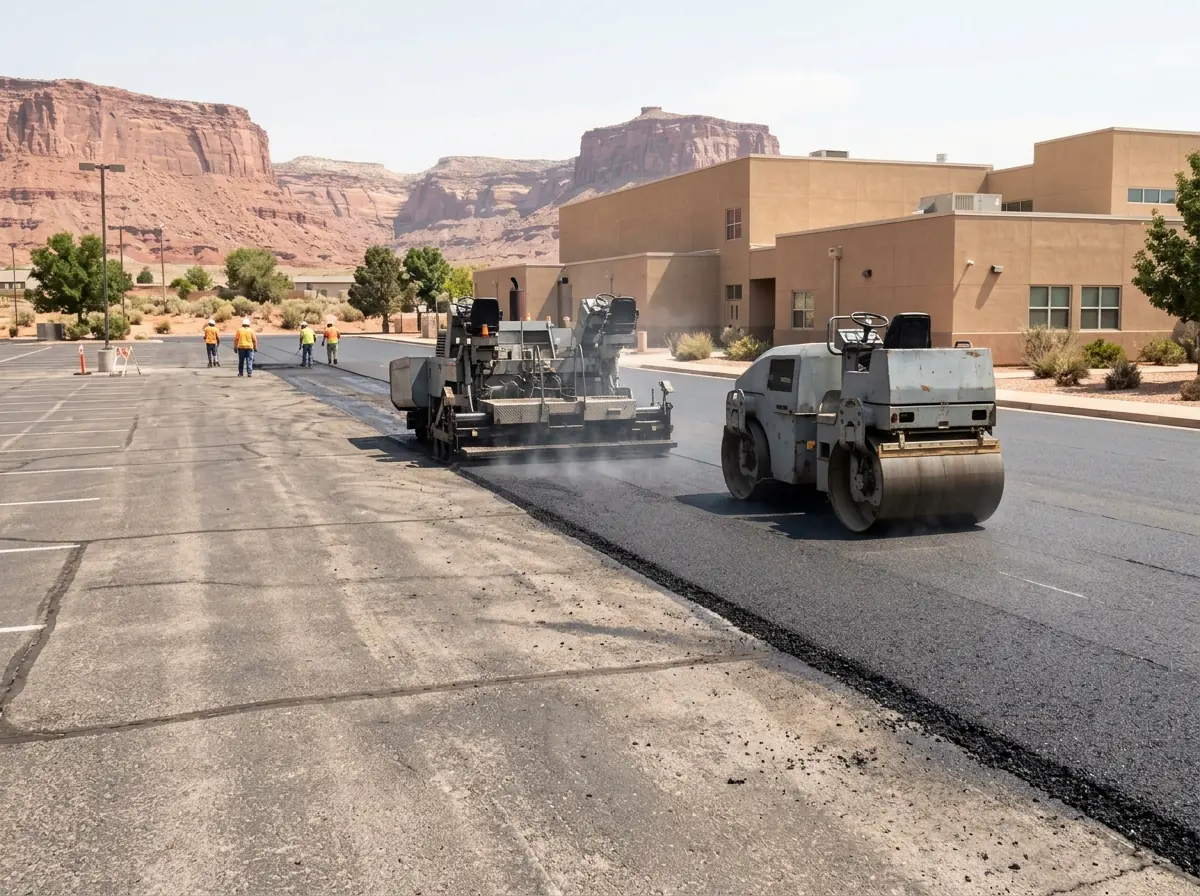

School paving usually lands in summer break, which in St. George means paving in the hottest weeks of the year. New asphalt needs extra time before heavy traffic in that heat; asphalt driveway paving gives the summer temperature figures and wait times. A full lot rebuild typically takes weeks, not days, so book it so the last stripe is down before teachers return. Sealcoating follows its own rule of 50°F and rising for 24 hours, so a fall break or a spring week can work for sealing, and parking lot sealcoating covers the cure and phasing. Churches have more flexibility, though holiday seasons and large events are worth marking on the calendar before the contractor picks dates.

Why St. George homeowners and property managers call St. George Asphalt Co.
- The estimate costs you nothing and commits you to nothing
- Ask for thickness, base depth and tear-out on the written bid
- Your job goes to one paving contractor, never a lead auction
- Property owners pay nothing for the introduction
Planning a Church or School Paving Project
Committees and school boards approve work on their own calendar, often months before the paving window. Working back from the date the lot has to reopen:
- STEP01
Walk the lot and set the scope
Have the contractor walk the lot with whoever handles facilities. Mark the failed areas, the low spots that hold water after storms, and anything that has to change: more stalls, a longer drop-off lane, accessible spaces nearer a door.
- STEP02
Ask for a base bid with alternates
Boards often fund in stages. A base bid for the repair or overlay, with sealcoat, restriping and an extra phase priced as alternates, lets the committee pick what fits this year's budget without rebidding.
- STEP03
Check permits before you commit to dates
New lots, expansions and full rebuilds that disturb an acre or more need construction stormwater coverage and a City-reviewed SWPPP before work starts, covered on parking lot paving. That review takes time, so it belongs before the start date is promised to anyone.
- STEP04
Sign a written contract
Get the scope, schedule, payment steps and final walk-through in writing. Before a board vote, get the contractor's state license number and run it through DOPL's online lookup.
What a Church or School Lot Bid Should Show
Phasing
Which sections close on which days, and what stays open for services, events or summer programs.Thickness
Asphalt and base depth after compaction, with bus lanes and dumpster areas called out separately.ADA
Accessible and van-accessible counts against the new stall total.Drainage
How low spots will be fixed, not only paved over.Restripe
Stalls, crosswalks, fire lanes and stencils as their own lines.
See parking lot repair if the lot only needs patching and a resurface this cycle, not a rebuild.
